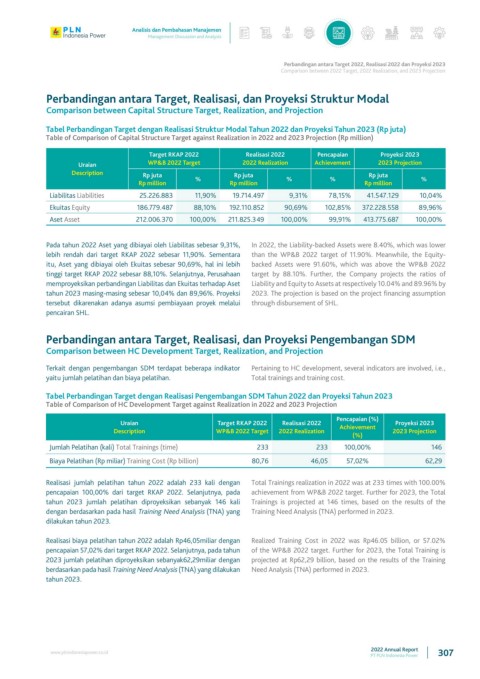

Page 307 - Annual Report 2022 - PLN Indonesia Power
P. 307

Analisis dan Pembahasan Manajemen
                                      Management Discussion and Analysis


                                                                       Perbandingan antara Target 2022, Realisasi 2022 dan Proyeksi 2023
                                                                       Comparison between 2022 Target, 2022 Realization, and 2023 Projection


            Perbandingan antara Target, Realisasi, dan Proyeksi Struktur Modal
            Comparison between Capital Structure Target, Realization, and Projection

            Tabel Perbandingan Target dengan Realisasi Struktur Modal Tahun 2022 dan Proyeksi Tahun 2023 (Rp juta)
            Table of Comparison of Capital Structure Target against Realization in 2022 and 2023 Projection (Rp million)
                                      Target RKAP 2022        Realisasi 2022    Pencapaian     Proyeksi 2023
                    Uraian            WP&B 2022 Target       2022 Realization  Achievement     2023 Projection
                   Description      Rp juta                Rp juta                          Rp juta
                                   Rp million    %        Rp million    %          %       Rp million     %
             Liabilitas Liabilities   25.226.883   11,90%  19.714.497    9,31%     78,15%    41.547.129   10,04%
             Ekuitas Equity        186.779.487   88,10%   192.110.852   90,69%    102,85%   372.228.558   89,96%
             Aset Asset            212.006.370   100,00%  211.825.349  100,00%     99,91%   413.775.687   100,00%


            Pada tahun 2022 Aset yang dibiayai oleh Liabilitas sebesar 9,31%,   In 2022, the Liability-backed Assets were 8.40%, which was lower
            lebih rendah dari target RKAP 2022 sebesar 11,90%. Sementara   than the WP&B 2022 target of 11.90%. Meanwhile, the Equity-
            itu, Aset yang dibiayai oleh Ekuitas sebesar 90,69%, hal ini lebih   backed Assets were 91.60%, which was above the WP&B 2022
            tinggi target RKAP 2022 sebesar 88,10%. Selanjutnya, Perusahaan   target by 88.10%. Further, the Company projects the ratios of
            memproyeksikan perbandingan Liabilitas dan Ekuitas terhadap Aset   Liability and Equity to Assets at respectively 10.04% and 89.96% by
            tahun 2023 masing-masing sebesar 10,04% dan 89,96%. Proyeksi   2023. The projection is based on the project financing assumption
            tersebut dikarenakan adanya asumsi pembiayaan proyek melalui   through disbursement of SHL.
            pencairan SHL.

            Perbandingan antara Target, Realisasi, dan Proyeksi Pengembangan SDM

            Comparison between HC Development Target, Realization, and Projection
            Terkait dengan pengembangan SDM terdapat beberapa indikator   Pertaining to HC development, several indicators are involved, i.e.,
            yaitu jumlah pelatihan dan biaya pelatihan.        Total trainings and training cost.

            Tabel Perbandingan Target dengan Realisasi Pengembangan SDM Tahun 2022 dan Proyeksi Tahun 2023
            Table of Comparison of HC Development Target against Realization in 2022 and 2023 Projection
                                                                                    Pencapaian (%)
                               Uraian                  Target RKAP 2022  Realisasi 2022            Proyeksi 2023
                             Description               WP&B 2022 Target  2022 Realization  Achievement   2023 Projection
                                                                                        (%)
             Jumlah Pelatihan (kali) Total Trainings (time)      233           233    100,00%               146
             Biaya Pelatihan (Rp miliar) Training Cost (Rp billion)  80,76    46,05    57,02%              62,29

            Realisasi jumlah pelatihan tahun 2022 adalah 233 kali dengan   Total Trainings realization in 2022 was at 233 times with 100.00%
            pencapaian  100,00%  dari  target RKAP  2022. Selanjutnya, pada   achievement from WP&B 2022 target. Further for 2023, the Total
            tahun  2023 jumlah pelatihan  diproyeksikan  sebanyak 146  kali   Trainings is projected at 146 times, based on the results of the
            dengan berdasarkan pada hasil Training Need Analysis (TNA) yang   Training Need Analysis (TNA) performed in 2023.
            dilakukan tahun 2023.

            Realisasi biaya pelatihan tahun 2022 adalah Rp46,05miliar dengan   Realized Training Cost in 2022 was Rp46.05 billion, or 57.02%
            pencapaian 57,02% dari target RKAP 2022. Selanjutnya, pada tahun   of the WP&B 2022 target. Further for 2023, the Total Training is
            2023 jumlah pelatihan diproyeksikan sebanyak62,29miliar dengan   projected at Rp62,29 billion, based on the results of the Training
            berdasarkan pada hasil Training Need Analysis (TNA) yang dilakukan   Need Analysis (TNA) performed in 2023.
            tahun 2023.









                                                                                             2022 Annual Report
             www.plnindonesiapower.co.id                                                                      307
